Weaving in New Fabric
Salt Lake City continues to grow up as well as out with 650 Main’s 10-story office tower and adjoining parking garage. By Taylor Larsen

Location, location, location.
The cliche from real estate folks is true for a reason. The hustle and bustle of urban areas are where people want to be, and the newest office building to open, 650 Main, is no exception.
Forward thinking from Dennis Tarro, Executive Vice President of Houston-based developers Patrinely Group, and his team helped bring the building to life as the real estate pros looked for emerging office markets and felt like they could add something of beauty and purpose to Salt Lake’s growing south side.

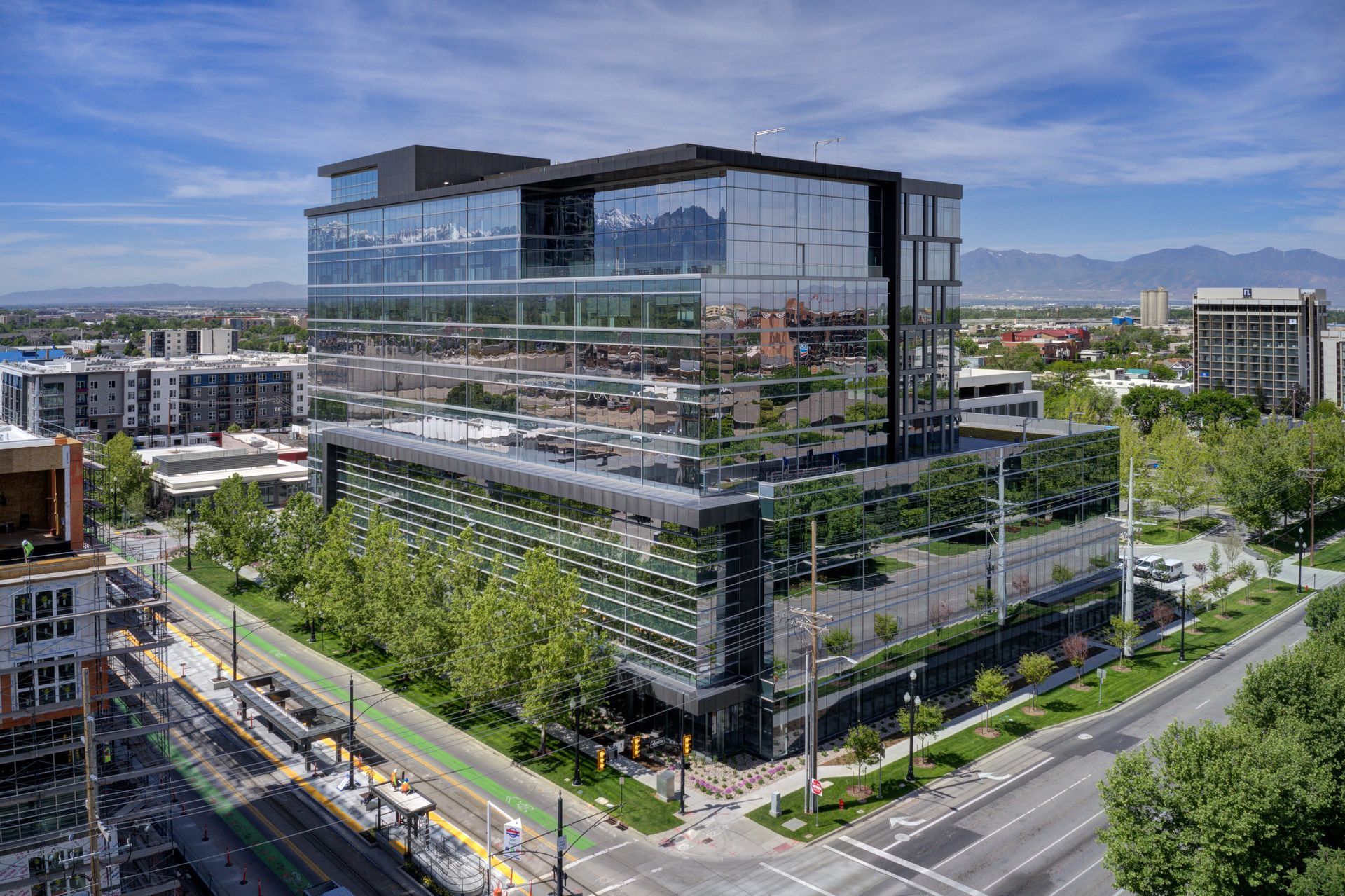

With its site between 600 South and 700 South on the multi-modal Main Street, it’s just a few blocks from all three of Salt Lake’s biggest east–west vehicle connectors to I-15. That ease of access was a major selling point to Patrinely Group, especially combined with the city and state’s other amenities.
“Salt Lake City checks a lot of boxes,” he said. Whether it is the outdoor-centric and accessible lifestyle, the international airport and the Beehive State’s high quality highways, or the affordability compared to other markets, Tarro and others felt like this would be a spot where Patrinely Group could not only succeed, but create a foothold for future development and be an integral part of building up an area of an ascendent city.
To create that foothold, Roger Soto, Design Principal for HOK’s Houston office, said that 650 Main needed to be a good urban neighbor that respected the existing downtown fabric while creating a desirable, walkable, office campus that is accessible to public transit. Accessibility grew as a group of developers near the 650 Main site, including Patrinely Group, ponied up the funds necessary to bring a TRAX Station within a minute walk from the front door.

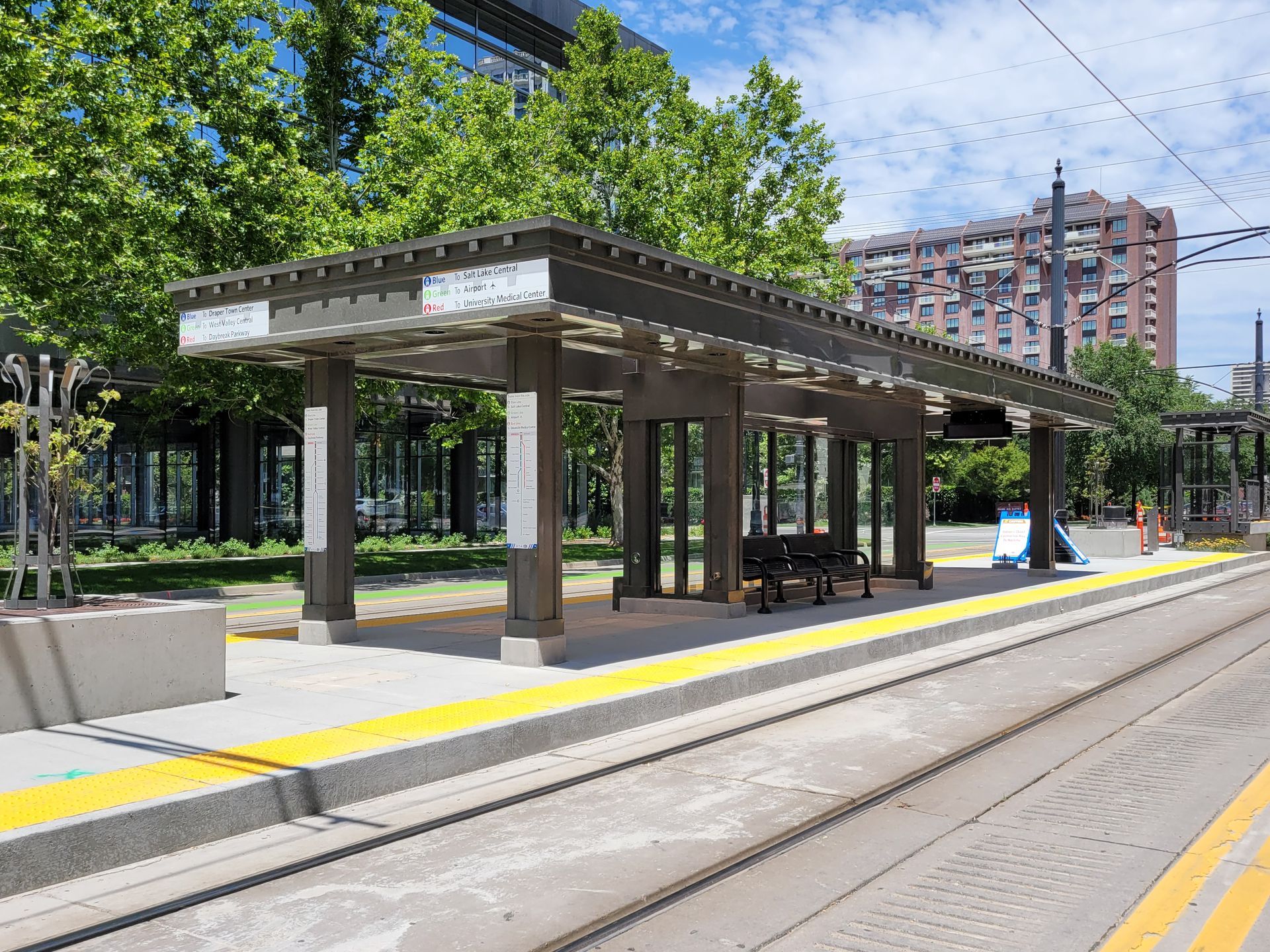

But everything has its costs beyond dollars and cents. Jeff Peterson, Vice President of Layton Construction, said staging space was at a premium. The TRAX station in the works occupied one of the sides of the construction zone while Layton and the construction teams erected 650 Main and its parking garage simultaneously. Add in “that we were [building] next to 600 South, one of the busiest streets in Salt Lake,” and the tight construction site meant their logistics work as a general contractor had to be precise.
He said that crane time was also at a premium, but one tower crane would not be enough to get the job done, and there was not enough space to fit a second tower crane. Instead, “we did it with two mobile cranes, squeezed in-between the office building and parking garage,” he said. To mitigate the potential issues from the hundreds of thousands of pounds of force exerted from the cranes, Peterson said that “a four-foot-thick base course pad made sure that the cranes were safe to operate” in a space that, today, is the office building’s lovely courtyard.
Communication between the crane operators was critical to make sure they were not picking over top of each other while ensuring everything was getting delivered and installed on time for the office building and 976-stall concrete parking garage.
“Cranes are a key part of our industry but can be dangerous if not used properly,” said Peterson. Construction crews came together for a job site huddle every morning to go over daily activities, especially crane picks, and make sure no one was working under the crane’s route.
It required another level of coordination, as the Layton team needed to be on top of material deliveries so the cranes could be most useful. Peterson mentioned that they resorted to an old school method. “We put a scheduling board in the trailer for when [crews] needed the crane,” Peterson said of the logistical success of the project. “We would referee when there was a conflict, but it worked pretty well.”
As the steel frame of the building completed, in came the glazing.
“We wanted to maximize glass,” said Bob Carnegie, Director of Architecture for HOK and Design Architect on the project. He said they worked with structural engineers to push the columns out and create cantilevers to clear the glass of any columns on this core and shell office. Floor to ceiling glass looking east to the Wasatch Mountains connects the building to Utah’s geographic majesty. Views from each of the 10 floors provide the visual connection to both the mountains and daylight—amenities that make Salt Lake and Utah so special.
Back on the ground level, the office building creates a “street wall” that engages with the street via floor to ceiling glass near 600 South's sidewalks. Soto and Carnegie explained how the building then steps back into a more standard office floor plate from the podium, a deliberate choice to respect the streets and the neighborhood, provide something architecturally compelling to energize the area, and ultimately fulfill their mission of being a good urban neighbor. Add in the nearby 4,000-plus-SF retail building that will be leased by Mexican restaurant Sol Agave, and you have a fully accessible office campus that can bring people onsite all day.
Soto described the area and the building as “fabric in the making.” And this fabric strand is modern. Metal panels function as if they were glazed into the curtain wall via the frame, even though the bent aluminum panels stick out in a non-continuous pattern.
“We worked closely with the [glazing subcontractor] JR Butler on the panels and glass to create different textures,” said Peterson of the work with their trade partner on glazing needs. Unitized and pre-fabricated panels help the façade to function as one continuous waterproofing system. Beyond utility, these framed views give tenants a lovely sight looking west.
Soto complimented how Layton suggested “a [façade] product that would fit perfectly with our goals.” Modern, efficient, fresh, forward-looking. “This is what tenants look for,” he continued.
The project’s efficiency resulted in LEED GOLD for the core and shell with high-efficiency glass and effective heating and cooling systems. Peterson said that Layton was able to recycle over 90% of their construction waste to bring another sustainability win to the project.
He was complimentary of developer Patrinely Group for their landscaping choices that will “add to the community and help with the beauty of the building.” From a bird’s eye view on the top floor, all of the new plants in their neat little rows make it seem like an entire nursery was placed on the site.
“We wanted to feel like the building and occupants weren’t sealed off from nature,” said Soto. They accomplished that via a terrace on the first setback from the ground floor plane and another terrace at the top corner of the building. The biophilic link is a unique and meaningful component of sustainability as the building creates engagement with the natural world.
But if you want engaging, stroll through the lobby. The 15-foot ceilings there make for a spacious and inviting entryway to the 300,000-SF office. Soto mentioned the hospitality feel designed for the lobby—with high-end furniture, lofty ceilings, and views outdoors, the space is certainly engaging, but the material choices really bring the energy. Marble flooring from Afghanistan, marble wall tile from Vermont, floor to ceiling glass, and courtesan oak wood veneer from Texas all combine to form a first-rate lobby for the post-Covid office.
“Developers have really changed their opinion on what a lobby should be,” said Soto. Gone are the days of ceremonial places of sheer elegance meant to be hallways to a company’s actual office. In its place are comfortable, usable spaces that combine with the utility of the provided amenities.
The lobby is a feature piece, but the fully stocked fitness center can stand alongside as a top building amenity. It links to the outdoors via a glass curtain Panda Horizontal Sliding Wall—a hybrid feature sure to turn heads. Add those to the courtyard at ground level, terraces above, and even full conference rooms, and it seems fair to ask whether the amenities arms race real. “Absolutely,” said Tarro. In order to get people back to work, Tarro mentioned, “you have to check all of those boxes.”
Doing so is akin to adding stitches in the fabric; the fabric of this building is strong. At every level of the project, the project team is sure that they have built something that combines well with the city’s downtown evolution.
Tarro said that office space is poised for a rebound, with tenants unsure what their space needs look like in a post-Covid office environment. He and Patrinely Group are confident that future tenants will fall in love with higher floor plates, higher ceilings, and top-shelf amenities. He explained how “[Patrinely Group] wanted to check the boxes” for clients looking to make the move to Utah’s emerging office market.
“I’m confident that this building offers what tenants want today,” said Soto. It weaves together location, building quality, and amenities into one inviting campus. It will be a strength to Salt Lake as the downtown extends southward.
